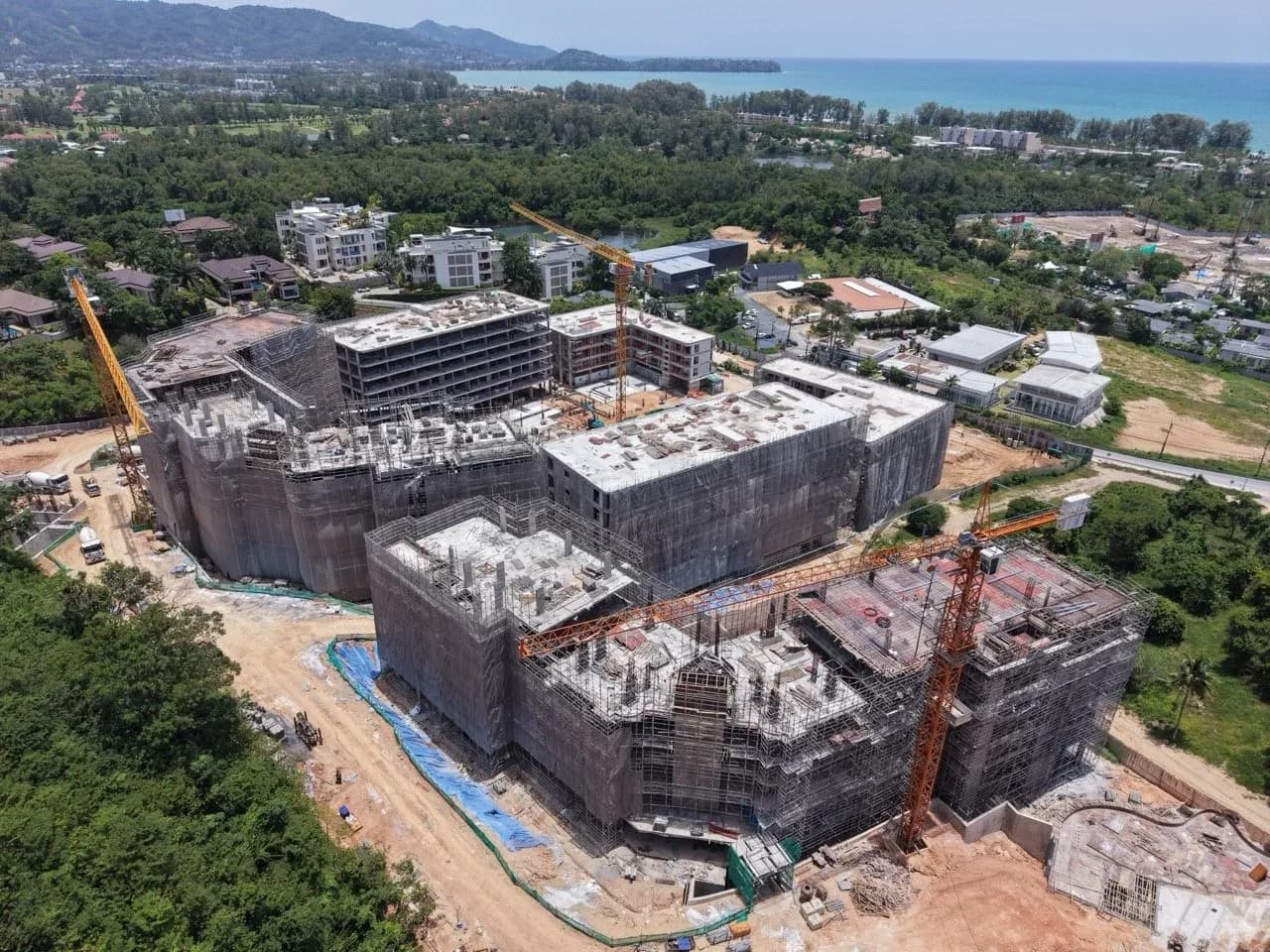

Drone photo, August 2026: blocks E–H topped out under scaffolding, Bang Tao bay behind

Chapter 04 · Construction

AYANA Heights Seaview Residence

Twenty monthly records since the groundbreaking on 18 January 2025: by the August 2026 update the structures of E, F, G and H were complete.

Request details

Drone photo, August 2026: blocks E–H topped out under scaffolding, Bang Tao bay behind

01/02

01Progress

Construction since January 2025: four structures already stand.

Every month brings a construction update with drone footage. In the August 2026 update the frames of E, F, G and H were complete, C and B were at their 6th floor, D had finished its foundation and A was in foundations. Instalments are tied to the foundation, structure and handover notice of your own building, not to calendar dates.

AFoundations, advanced stage
BStructure at the 6th of 7 floors
CStructure at the 6th of 7 floors, pool under way
DFoundation complete, MEP started
EStructure complete, walls and MEP
FStructure complete, roof floor
GStructure complete, walls and MEP
HStructure complete, finishing and MEP

Floors of structure per block · August 2026. Townhouses: stage on request.

02Month by month

Every record since the groundbreaking.

  1. August 2026

    Four structures complete

    Building H is in architectural and MEP works; the frames of E, F and G are complete, with F building its roof floor. C is at its 6th floor with the pool under way, B has reached the 6th floor, D has finished its foundation and started MEP work. Retaining walls continue across the site.

    • HArchitectural and MEP works
    • EStructure complete
    • FStructure complete, roof floor
    • GStructure complete
    • C6th floor and the pool
    • B6th-floor columns
    • DFoundation complete, MEP started
    • AFoundations
  2. July 2026

    H in finishing, three more frames done

    Building H works on its architecture and MEP, the frames of E, F and G are complete, C and B are at the 6th floor and D has completed its foundation.

  3. June 2026

    E and G topped out

    Building H moves into architectural and interior work; E and G have completed their structural frames and started walls and MEP. F is at its 6th-floor columns, C at the 5th floor with the pool, A and D are in advanced foundations; roads and retaining walls continue.

  4. May 2026

    E reaches its roof

    Building E reaches its roof floor. G and H are in wall and MEP work, F is at its 4th-floor columns, C rises through its 3rd floor with the pool started, and the foundations of A and D continue.

  5. April 2026

    G and H at 99%

    Buildings G and H reach 99% of their structure and start wall cladding and MEP. E is at its 6th floor, F at its 3rd-floor columns; B and C continue their floors and structure, A and D their foundations.

  6. March 2026

    G and H at 98%

    G and H are at 98% of their structure and start walls and MEP; E has reached its 5th floor and F its 2nd; B and C have columns and structure under way, A and D their foundations.

  7. February 2026

    Foundations nearly done

    G and H reach 97% of their structure, with stairs, MEP and wall panels under way. E is at its 3rd floor, B is building its first-floor slab and water tank, and Building A's foundation is 89% done.

  8. January 2026

    Six foundations complete

    The foundations of B, C, E, F, G and H are complete, A's is at 75%. H reaches 95% of its structure and G 85%, E 10% and F 2%; B works on its basement slab and retaining walls, A, C and D on columns, beams and footings.

  9. December 2025

    Into the structural phase

    The foundations of E, F, G and H are complete and the piling of A, B and D is finished. H reaches 47% of its structure and G 30%; the site moves to pile cutting and the first columns and walls.

  10. November 2025

    H at its second floor

    The piling of A is complete; B, C and D work on pile cutting, footings and excavation, E and F on raft foundations and walls. G moves to columns and scaffolding, H to its second-floor structure; the retaining wall of road zone 1 is complete.

  11. October 2025

    Piles and raft foundations

    B starts pile driving, C moves to pile cutting and D to excavation and pile testing; E and G cut their piles, F and H build raft foundations.

  12. September 2025

    The raft foundation of H

    Building H leads with its raft foundation, C has finished pile driving, and B, E, F and G move through early works.

  13. August 2025

    Retaining walls

    Retaining walls near completion, with new piling and foundation milestones across several buildings.

  14. July 2025

    Piling across C–H

    Piling is completed across Buildings C to H, with retaining walls advanced and backfilling under way.

  15. June 2025

    Piling of E, G and H done

    Piling is completed for Buildings E, G and H, with major retaining-wall works and the ground for Building C prepared.

  16. May 2025

    Earthworks of C

    Piling and foundation work advance, and Building C completes its earthwork excavation.

  17. April 2025

    Piling and foundations

    Piling and foundation work continue across the site.

  18. March 2025

    G and H fully piled

    Piling is 100% complete on Buildings G and H, with progress on E and F.

  19. February 2025

    Concrete piling begins

    Concrete piling starts on site.

  20. January 2025

    Groundbreaking

    Blessing and groundbreaking ceremony in Layan on 18 January 2025.

03Next step

Ask for the schedule of your building.

We send the current construction schedule of the block you choose and the payment stages tied to it, in writing.

Request details

We answer in writing

Today's prices, the plans and the payment schedule for the homes or the format you name.

Today's offerReply within 15 min in working hours

An offer for your chosen home

AYANA Heights Seaview Residence

Prefer to chat? The same request, in WhatsApp:Open WhatsApp
Add a comment · optional

By sending, you ask Invest Phuket to contact you about this enquiry. Your details are used to respond to your request.

PreviousAYANA Park & resort lifeMain pageAYANA Heights Seaview ResidenceNextLayan & Bang Tao
Lina, sales manager at Invest Phuket

Your sales manager

Lina · Sales manager

Tell us who will live there, how you will use the home and your budget. We pick the free homes on the grid that fit, send today's price, the plan and the payment schedule of the building in writing, and arrange your visit to the site and the show unit.

Request detailsCall +66 80 053 3846

Reserve a home at AYANA Heights

Name a unit code, a format or a budget: we answer with the free homes, today's prices and the reservation steps.

Lina · Sales managerReply within 15 min in working hours

An offer for your chosen home

AYANA Heights Seaview Residence

Prefer to chat? The same request, in WhatsApp:Open WhatsApp
Add a comment · optional

By sending, you ask Invest Phuket to contact you about this enquiry. Your details are used to respond to your request.

AYANAHeights Seaview Residence
Residences & plansBuildings & floorsAYANA Park & resort lifeConstructionLayan & Bang Tao

Invest Phuket is an independent property sales agency in Phuket.

© 2026 INVEST PHUKET · info@investphuket.com
Request details
